The La Solana project consisted of 58 two,
three and four bedroom town homes targeted at first time low and moderate income
buyers. The project was developed by Eden Housing a Hayward based housing
oriented nonprofit organization. La Solana was one of several projects created
as part of the U.S. Department of Housing and Urban Development's "Housing Cost
Reduction Demonstration Program." The idea behind that program was to develop
and field test ideas for reducing the cost of housing production in order to
achieve affordability. The methods employed included streamlining the HUD
approval process, use of HUD Section 236 financing, and other techniques. Great
emphasis was also placed on energy efficiency in order to reduce the continuing
cost of ownership.
The basic plans are simple and
straightforward, and the finish materials are drawn from a builder's standard
list of materials. However, as it turned out the pursuit of high energy
efficiency resulted in construction that was very complex and costly. Each town
home had both solar assisted water heating and space heating.
The solar assisted water heating was
consistent with the state of the technology at the time of construction, roughly
1981. Each unit had a regular electric water heater, a solar storage tank, roof
mounted collector panels, and the necessary electronic controls and valves to
make the system work. The entire system followed standard designs and was built
from off the shelf components.
The solar assisted space heating was
entirely unique. Double glazed windows and patio doors, extra weather stripping,
and careful sealing of the building envelope were part of the plan as well as
foam insulation under the concrete slab first floor, and substantial insulation
in the second floor attic space. Those things were well accepted and tested
methods at the time. But, solar space heating generally involves providing a
"storage mass" which is heated by the sun during daylight hours and which then
gives off the stored heat during the evening and night hours when added heating
is most often needed. The designers assumed, and I think correctly, that for
many people an exposed concrete or tile first floor finish would not be
acceptable. It was assumed that most buyers would want carpeting. But, carpeting
would insulate the concrete slab from solar heating and render it useless as a
"storage mass." The designers then turned to walls as a potential location for
the "storage mass." By adding large quantities of sand to gypsum plaster and
then applying a 2" thick layer to all of the walls separating the units
sufficient mass was achieved. Unfortunately, the devil is often in the details,
and the ultimate detailing of the technique proved very difficult for all of the
contractors involved. However, in the end the desired result was achieved and
the end product is shown in the snapshots below. These were taken at various
stages of construction, through to the finished model.
You can click on the photos below for a larger version. Use
your browser's "Back" button to return here. Click "Home" to return to the
homepage. HOME
|
|
|

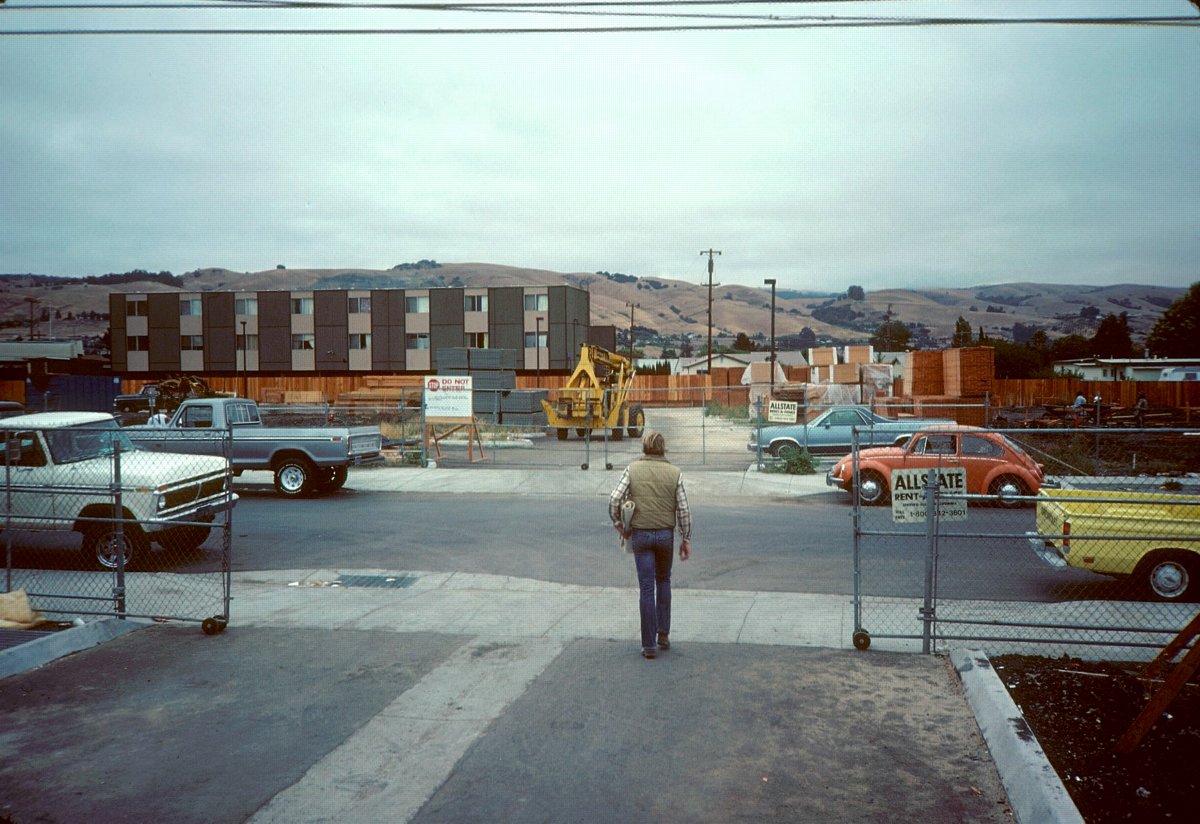

The Lot(s)
The La Solana site consisted of two lots of about 2 acres each. Located along Tenneysaon Road, they were separated By Harvey Avenue. This view is the lots from across Tenneyson. |
|
|
|
The Lot(s)
This view is from the Harvey Avenue corner of one of the lots looking toward Tenneyson. |
|
|
|

Footings

Footings are poured and drain plumbing in place. |
|
|
|
|

Preparing For The Slab Pour
The foam insulation, reinforcing steel and pipework is in place, and perimeter forms are almost ready for the slab pout. |
|
|
|

Preparing for Footing Pour
There were a total of eight buildings on the site. Here the steel and drain lines are in place ready for footing pour. |
|
|
|
West Side Buildings & East Foundations

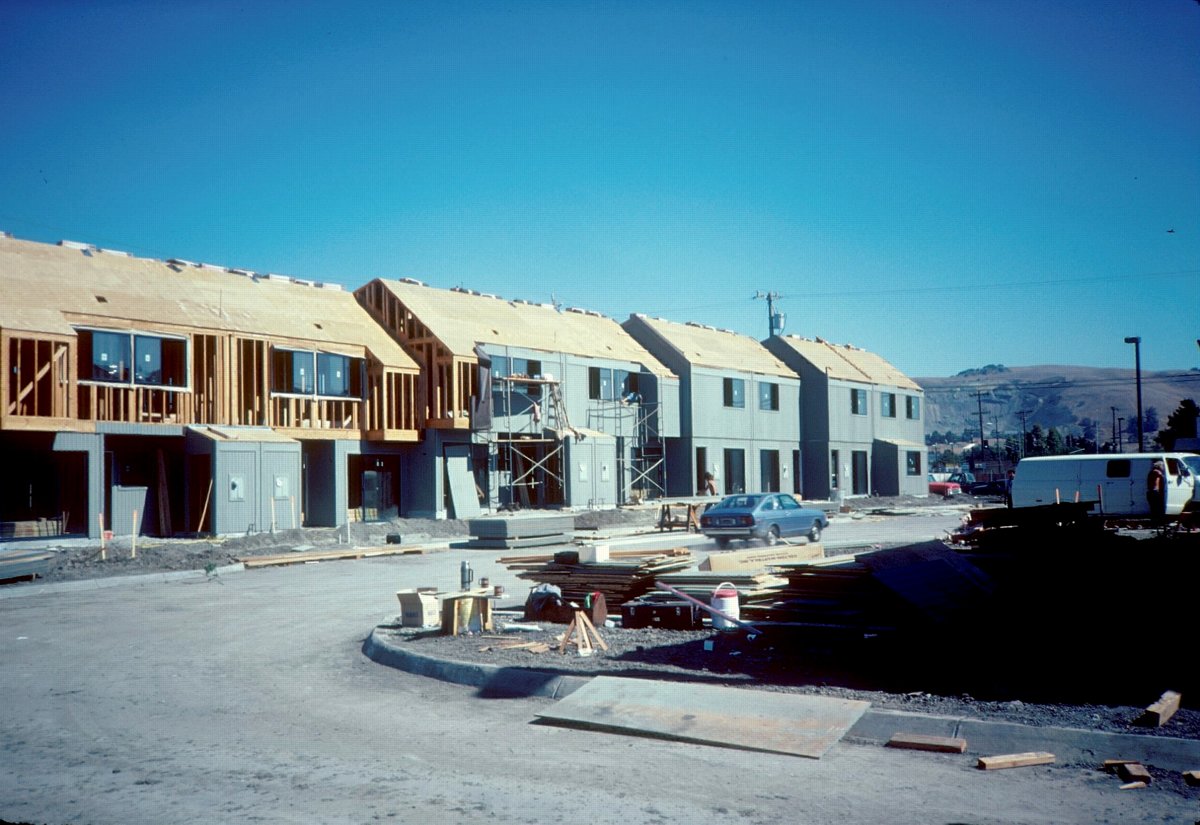

The buildings on the west side of the site are well along in framing while the foundations are being completed on the east side. |
|
|
|
|

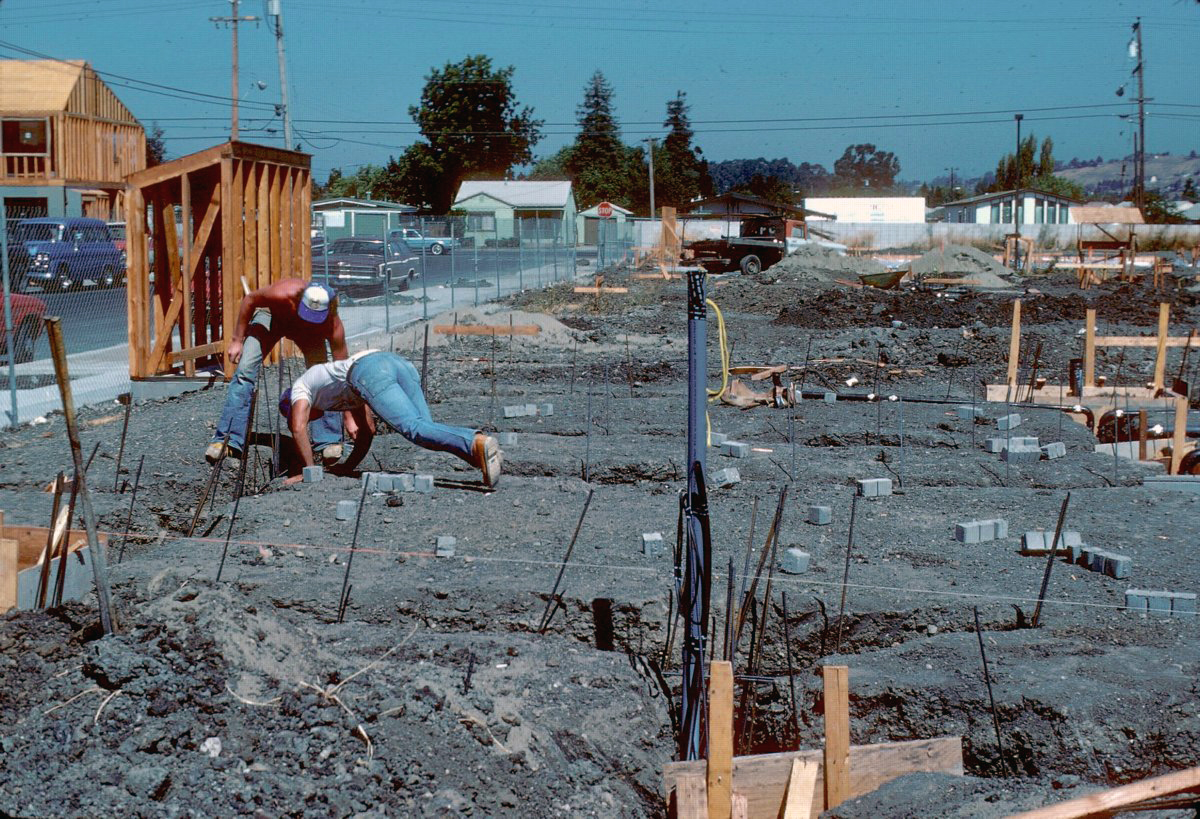

Foundations
Final check on footings. |
|
|
|
Concrete Pour
Footing pour in a light rain. An early decision to complete all street work through curb, gutter and asphalt proved important as other builders working nearby projects without completed streets were shut down for weeks by rain. |
|
|
|
The Bone

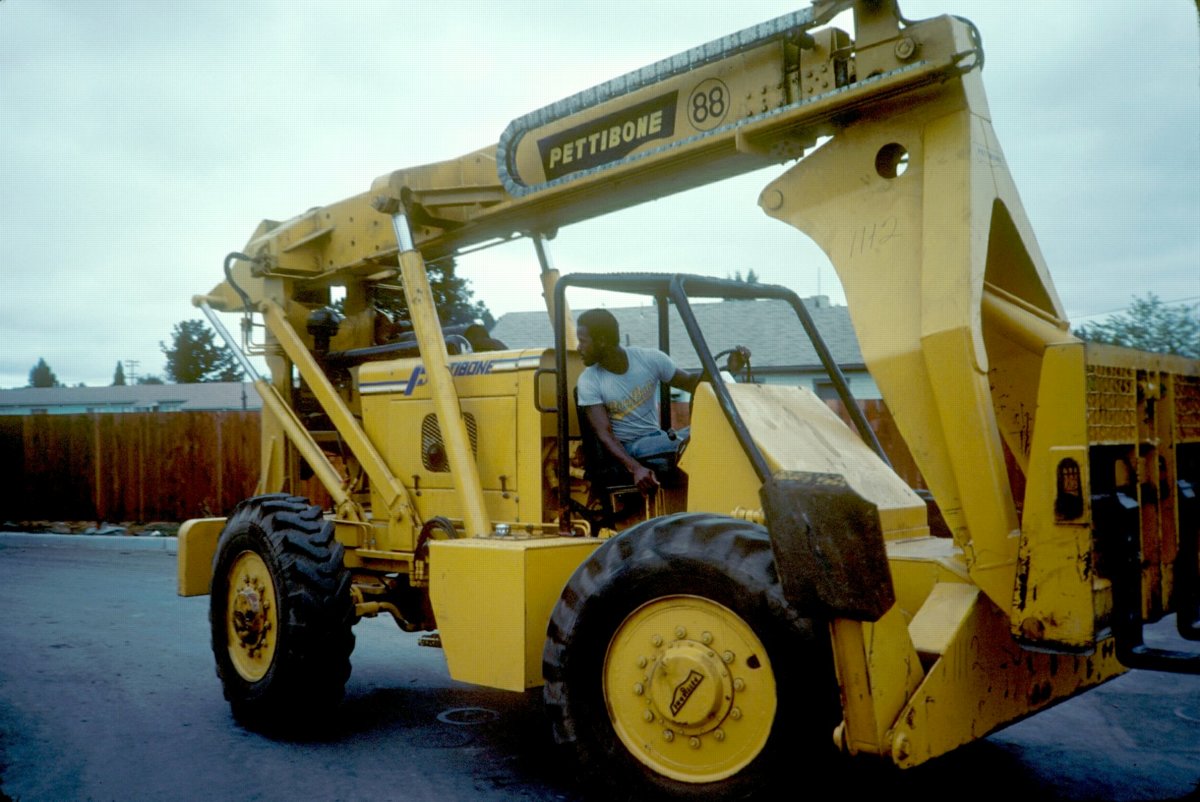

Our B-88 Pettibone could reach material stores in the paved area and set heavy loads on the concrete slabs overreaching the muddy yards. This allowed work to proceed under almost any conditions. |
|
|
|
|

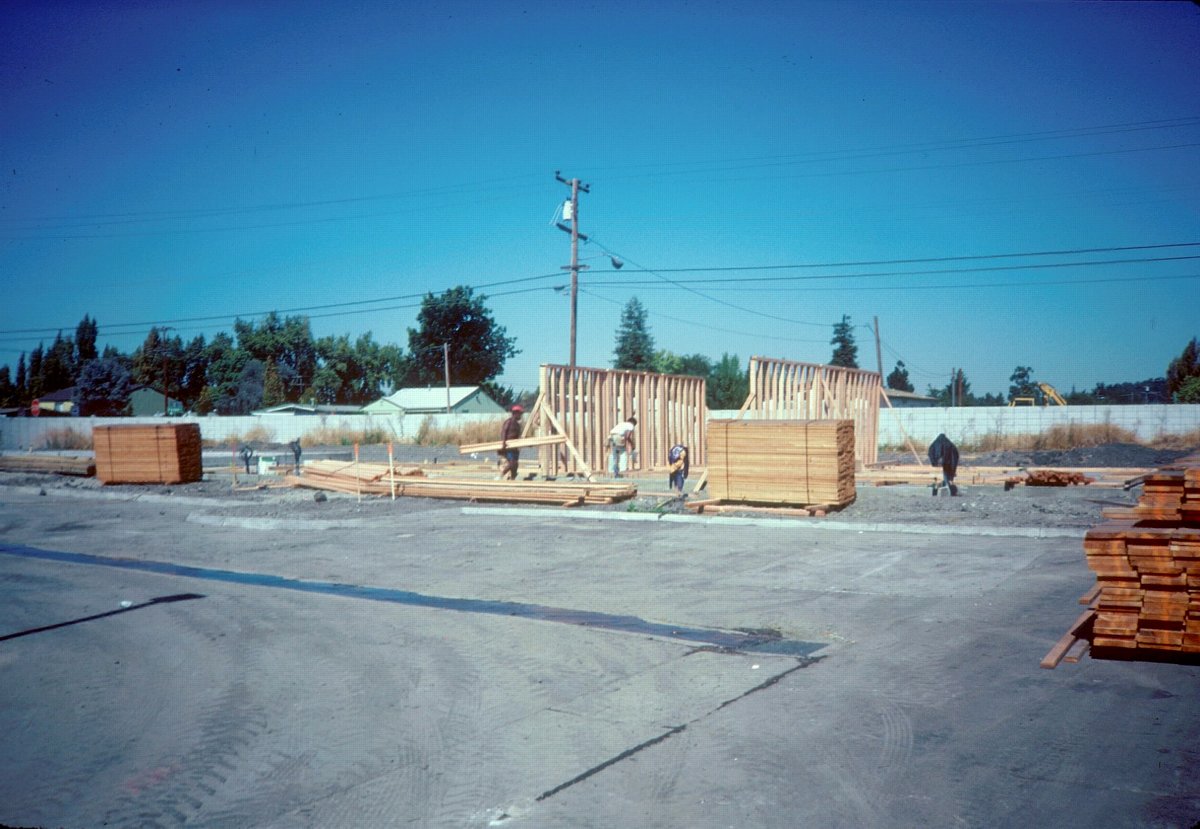

Framing Starts

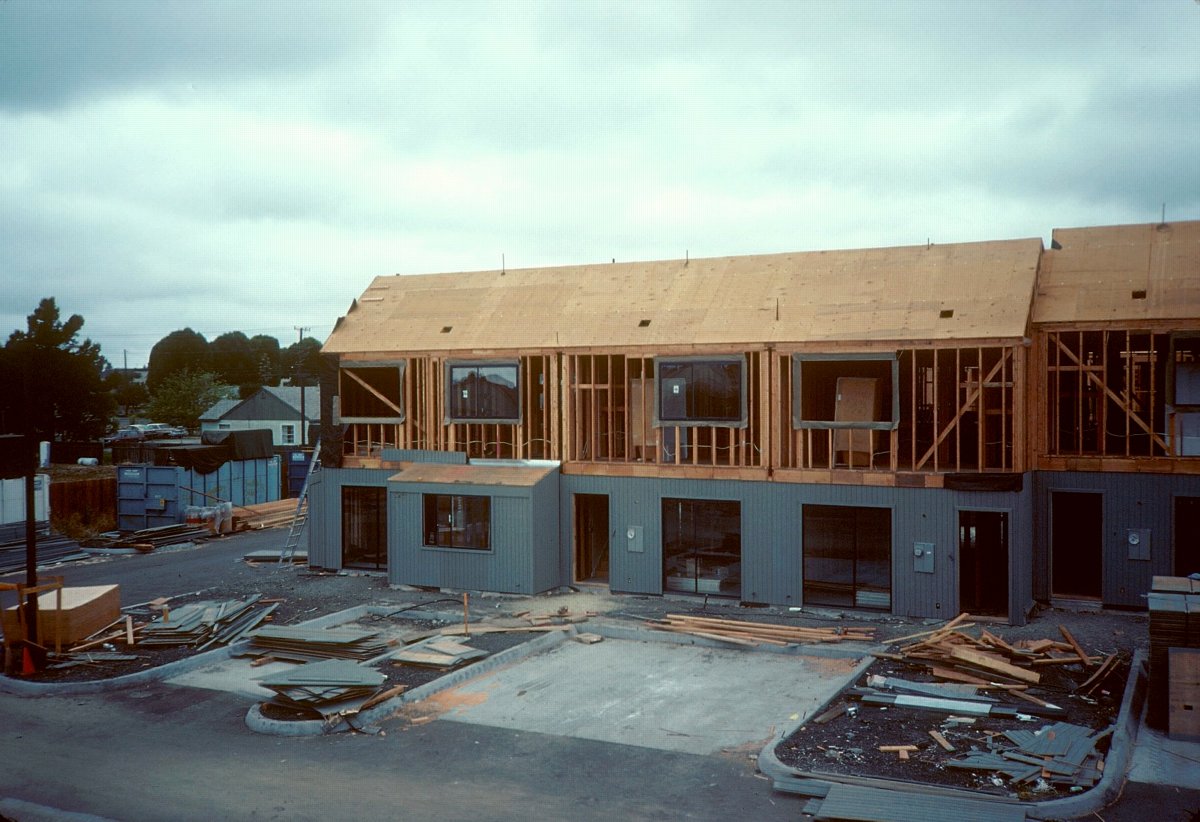

The framing starts on a newly completed slab. |
|
|
|

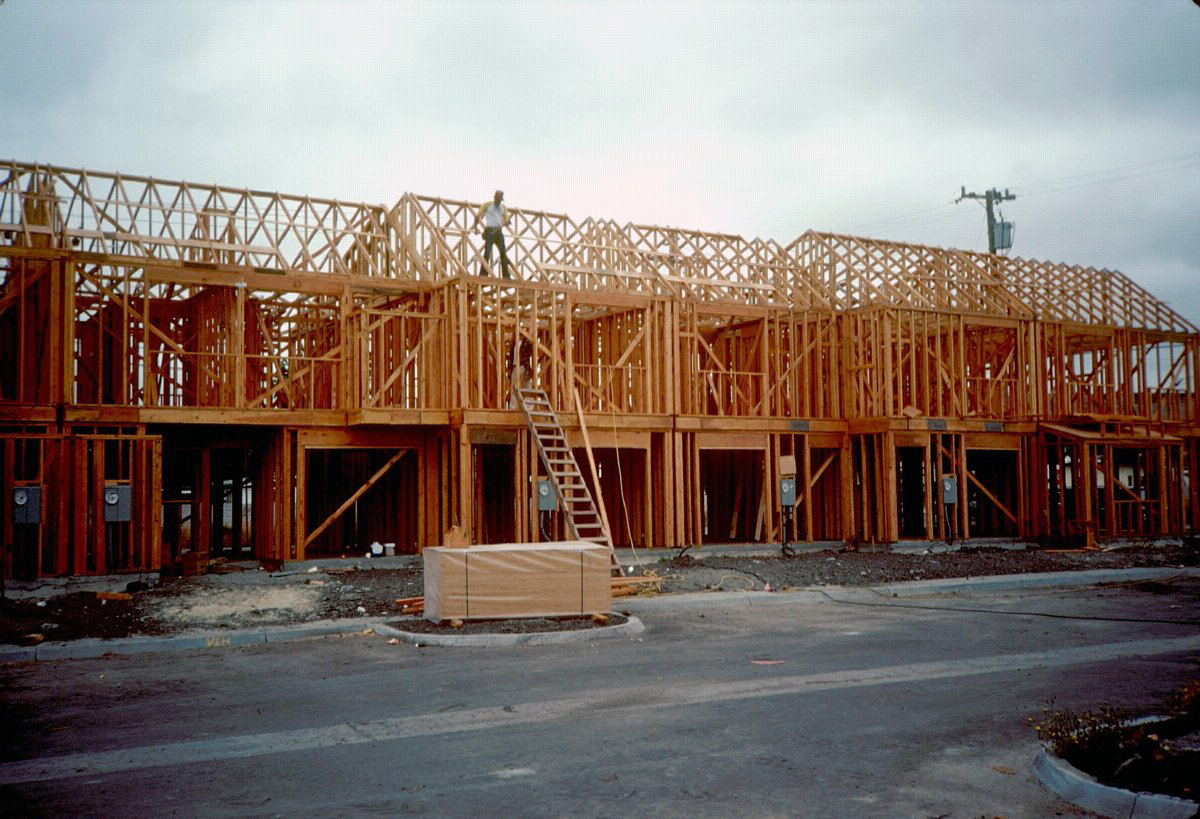

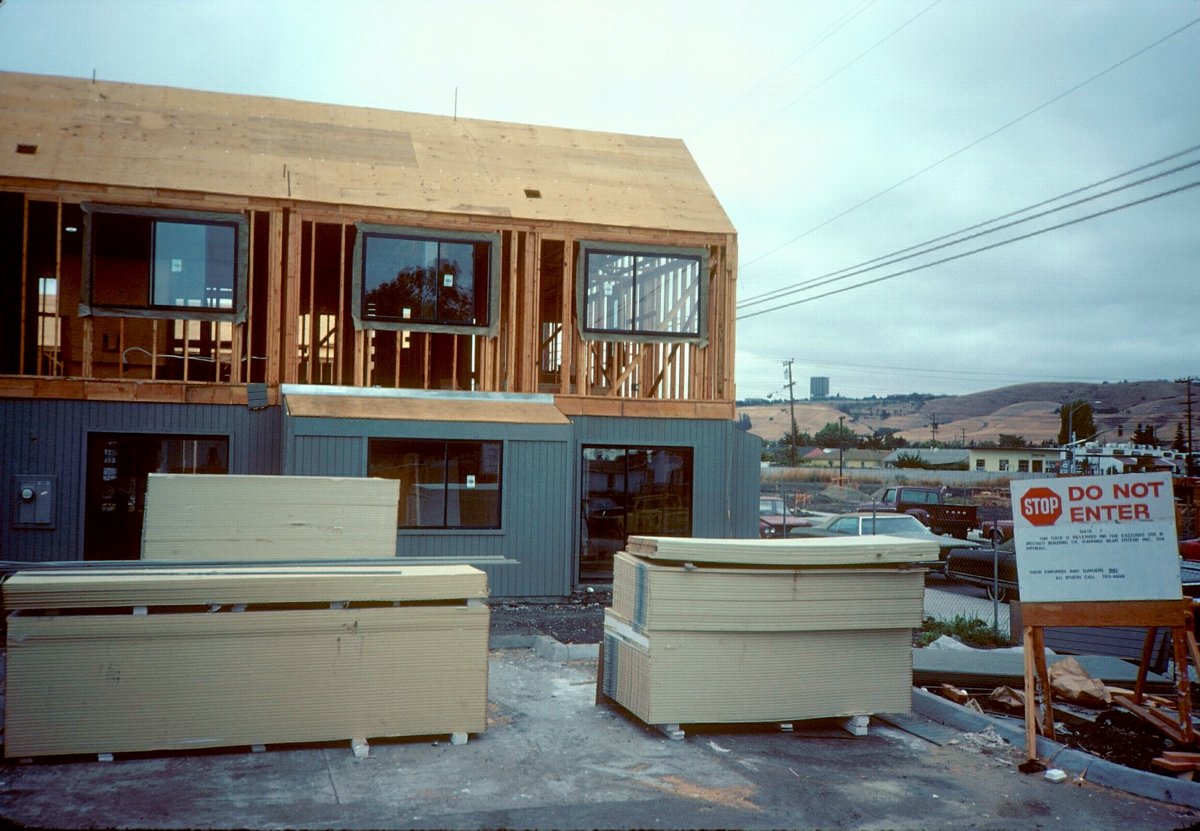

Framing Nearly Complete
Framing is nearly complete on this building. |
|
|
|
East Site
Foundation work undersay on the east site. Note the stacks of material ready for use. |
|
|
|
|

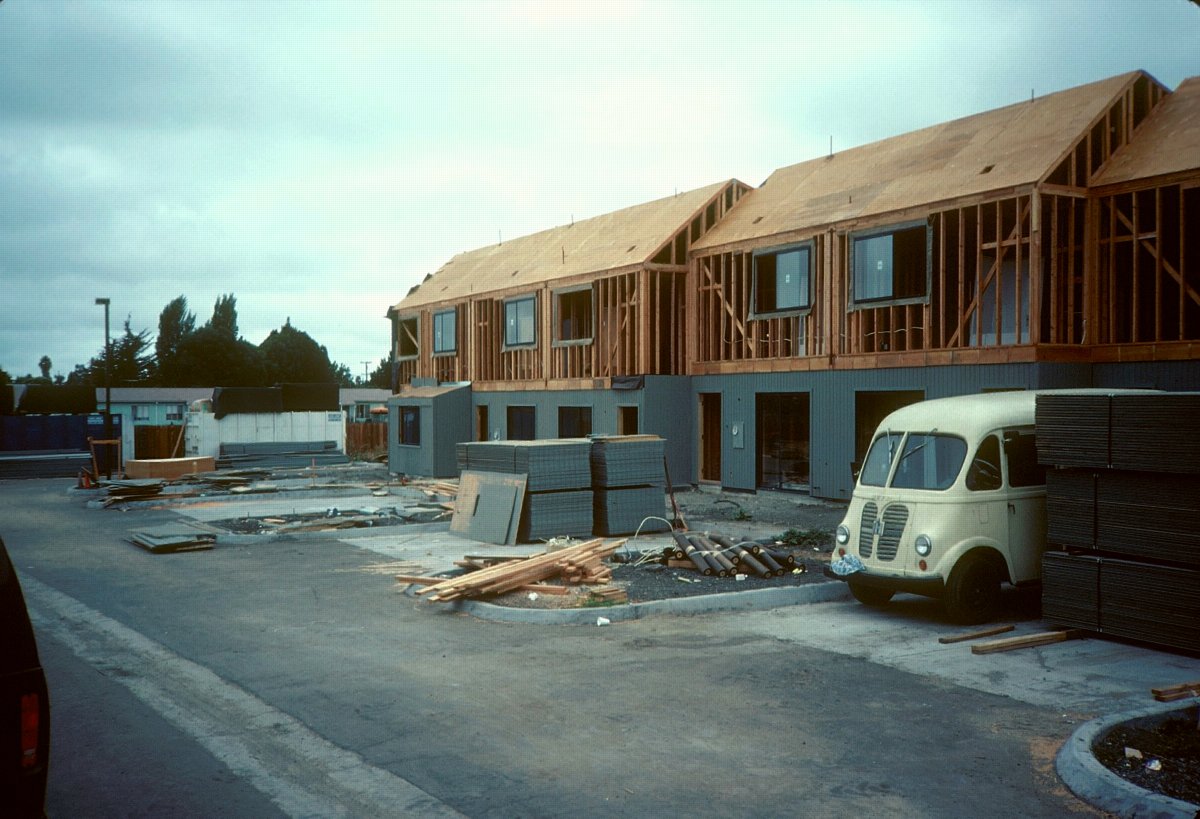

Framing and Finish

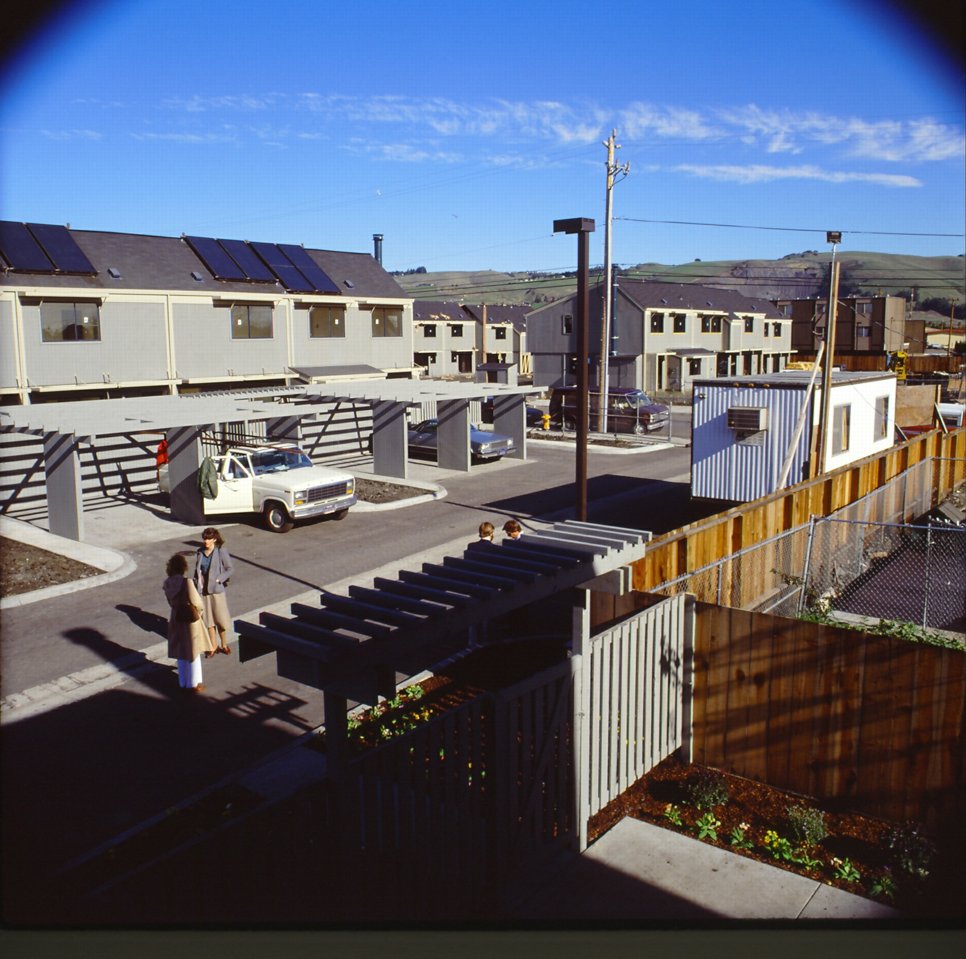

Framing underway on the east side while finish work is being done on the west. Note that the solar water heating panels are in place on the west side building. |
|
|
|

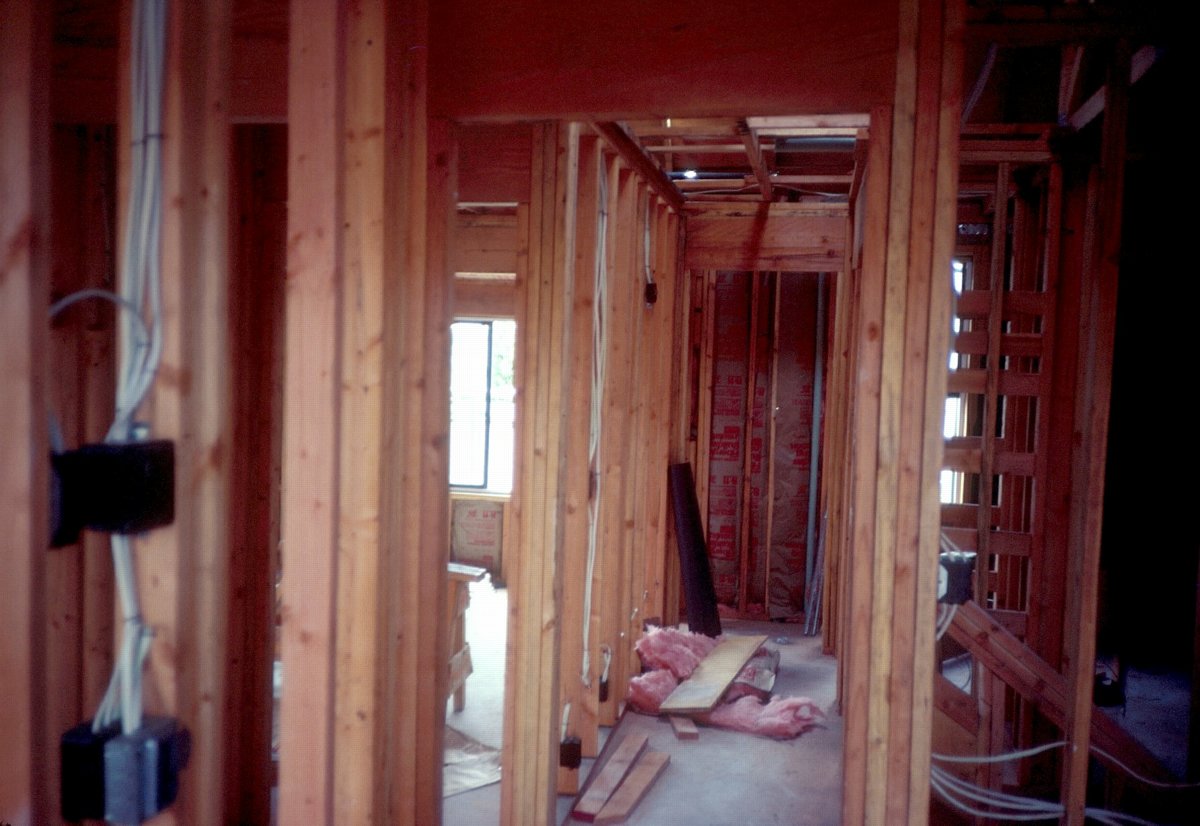

Interior Under Construction
Typical of the interior under construction. Wiring and plumbing are in place and insulation is underway. |
|
|
|

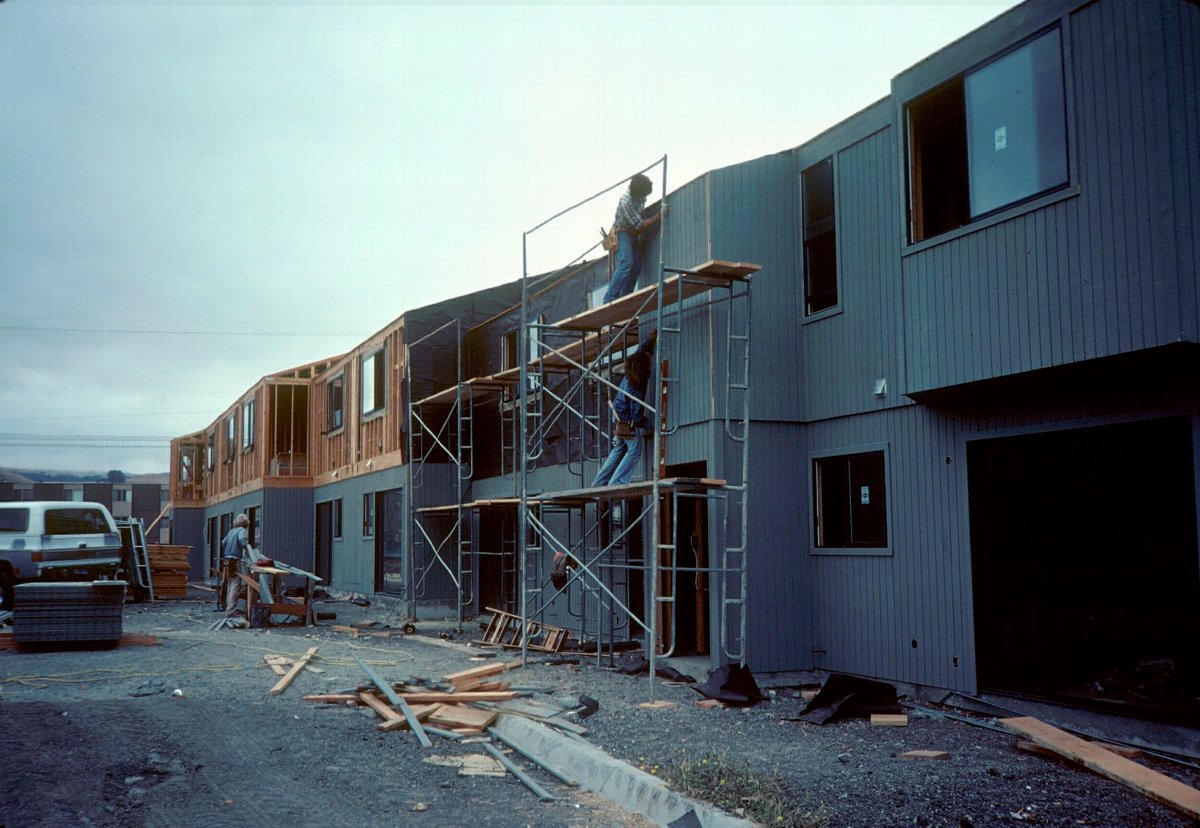

Siding
The plywood was prepainted. With careful handeling in the field only minor touch up and trim painting was required. |
|
|
|
|
Siding Underway
Note the stacks of drywall ready to be stocked in the buildings. |
|
|
|
Siding
The siding, like all other steps in the process was completed in sequence, one building at a time. |
|
|
|
Prepainted Siding
Prepainting the siding saves time and labor over paining after installation, but the key is careful handling in the field. Careless handling can damage the paint requiring extensive touch up, or complete repainting. |
|
|
|
|
Underway
|
|
|
|
Clean Up Stage
This building is nearing completion. Interior painting is underway and teh exterior is cleaned up prior to construcion of the covered parking, fencing and yard storage. |
|
|
|

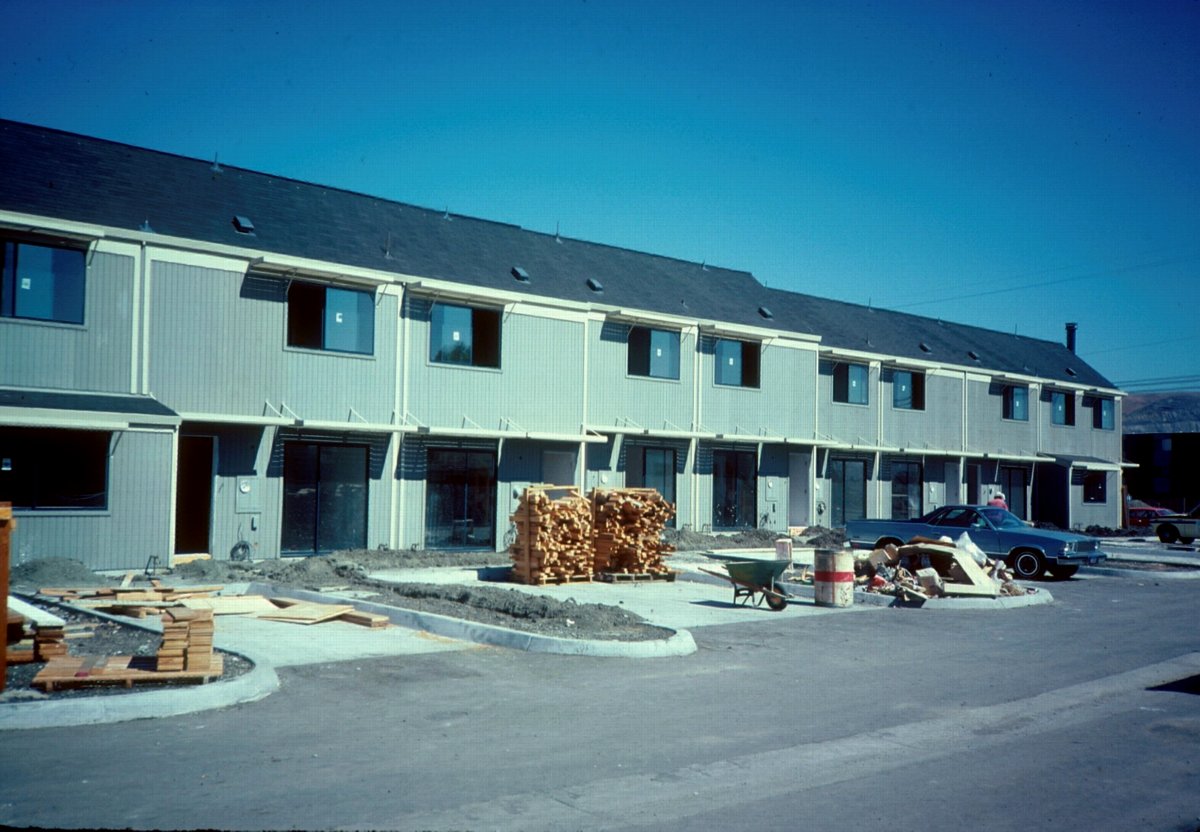

West Side Nearing Completion

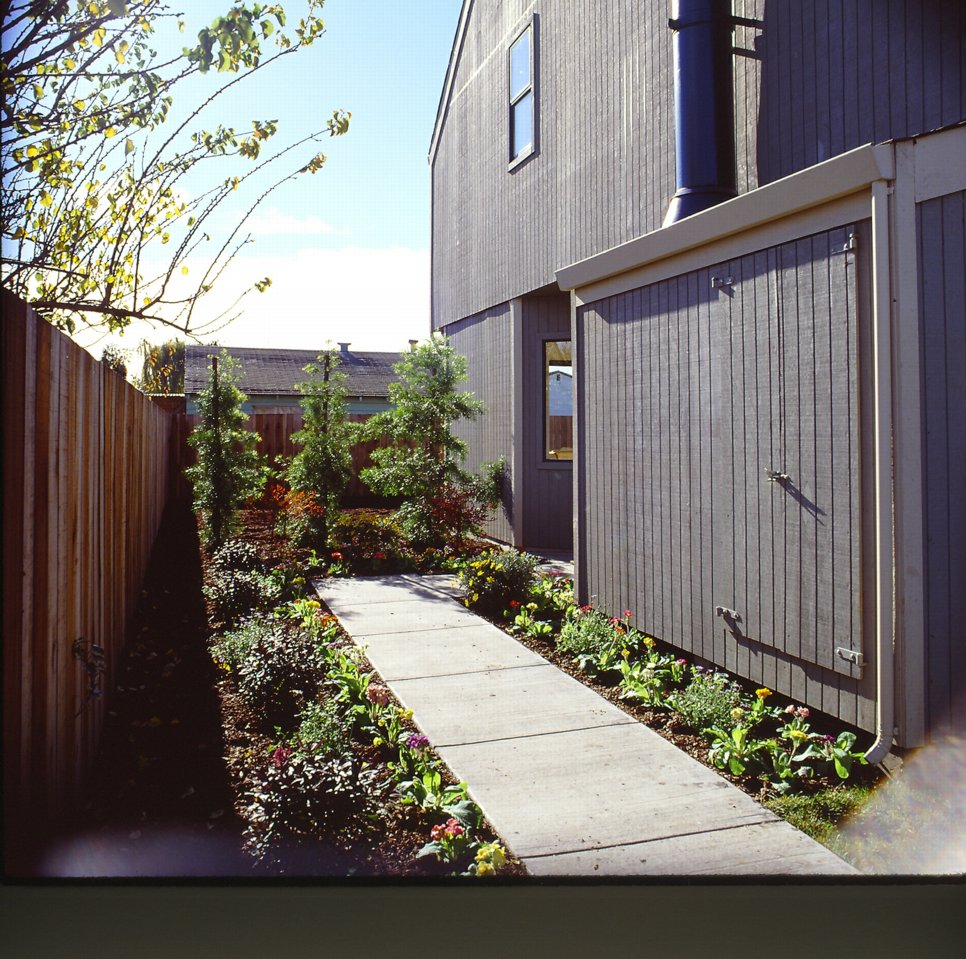

The parking structures, fencing and yard storage are nearly complete on the west side and the model units (right foreground) are being landscaped. |
|
|
|
|

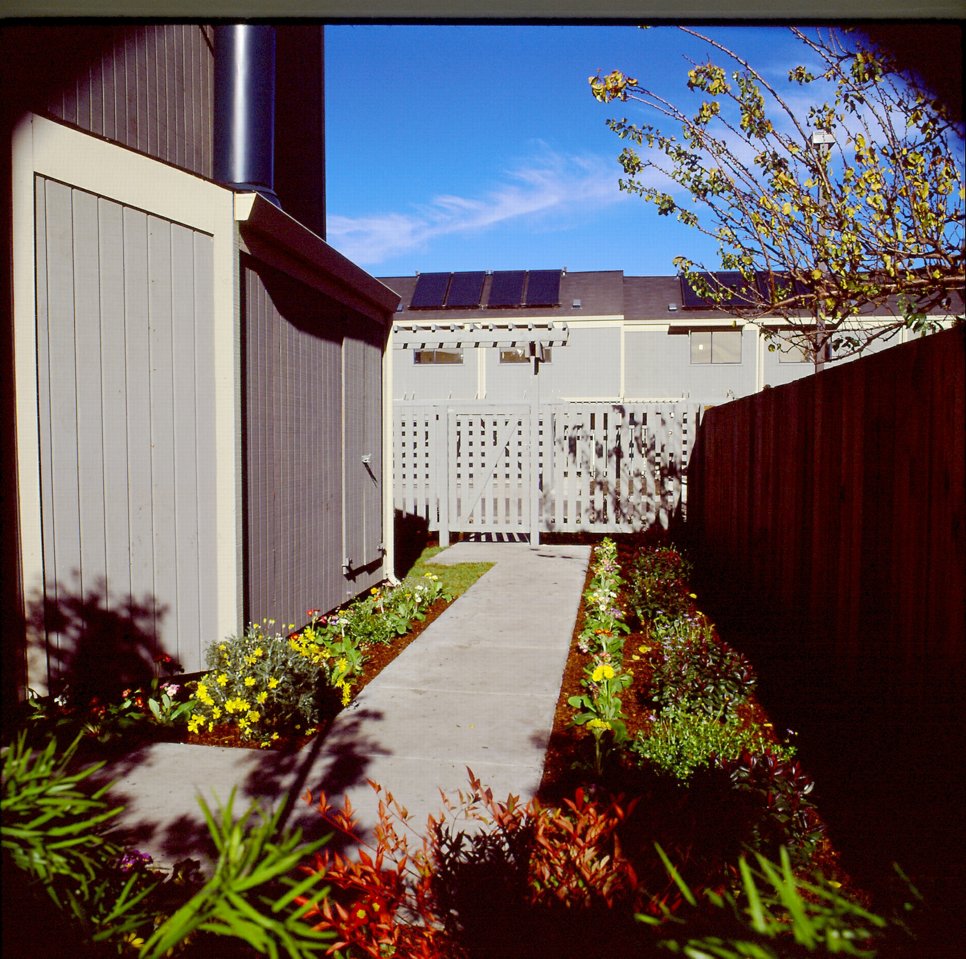

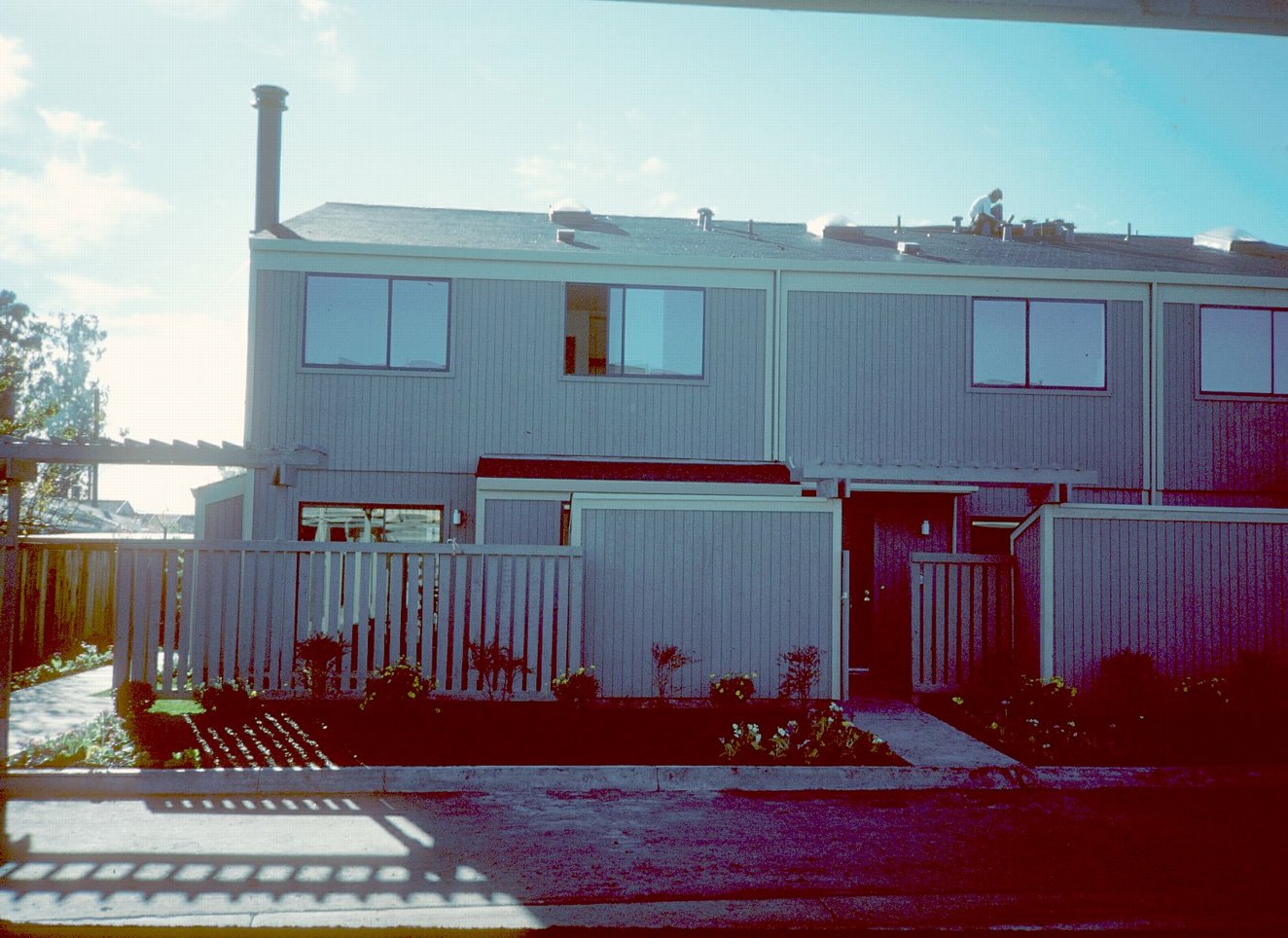

Model Units, Exterior
The model units are nearly ready for display. |
|
|
|
Model Four Bedroom Entry
The end units were all four bedroom with fireplace. |
|
|
|

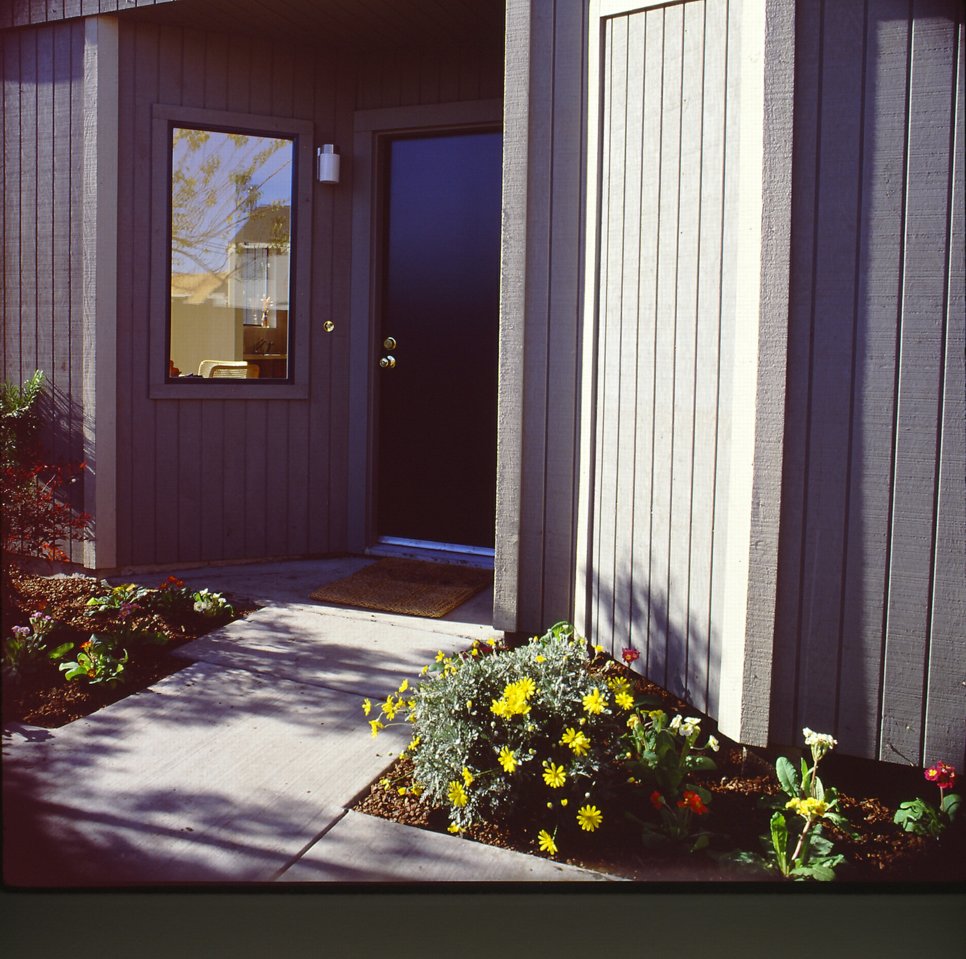

Entry
The entry of a four bedroom end unit. |
|
|
|
|
Entry Walk
|
|
|
|
Kitchen
Typical kitchen includes the full range of standard features. |
|
|
|
Livingroom with Fireplace
Only the four bedroom units have fireplaces but all are bright and attractive. |
|
|
|
|

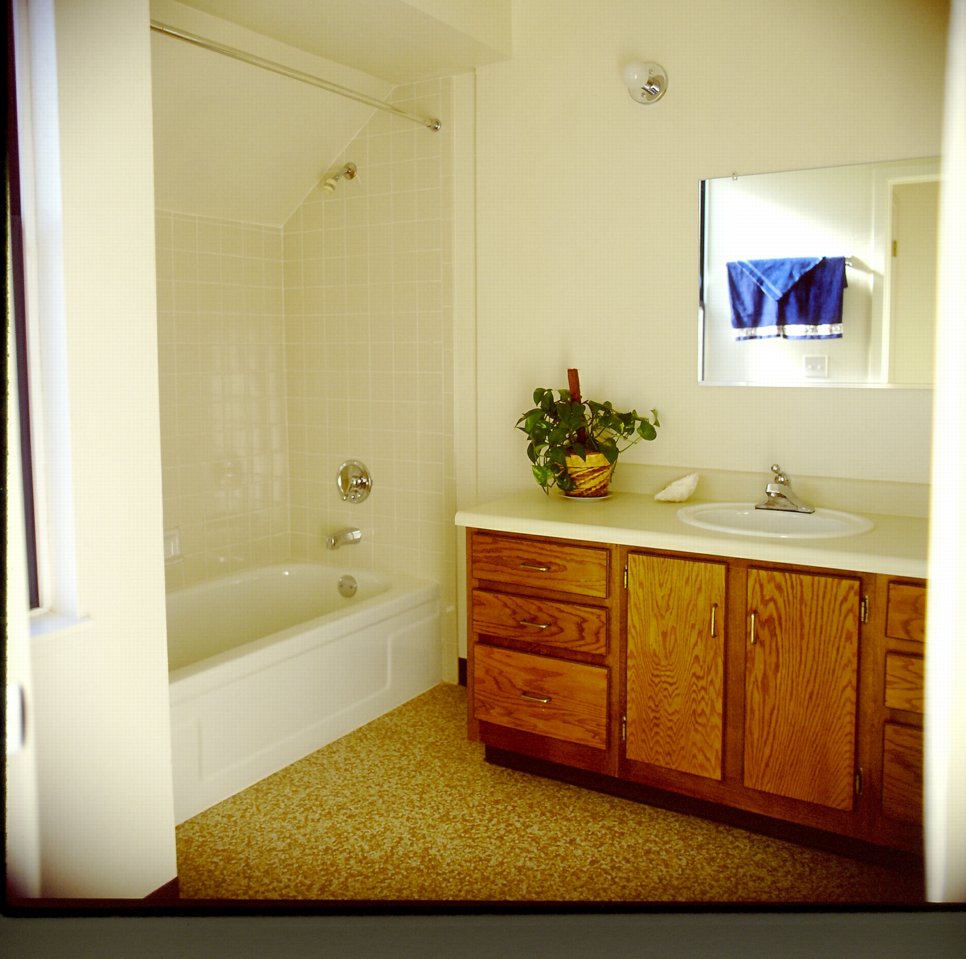

Master Bath
Master bath features ceramic tile tubs and attractive cabinets. |
|
|
|
Master Bedroom
To aid in even distribution of heat a duct and small fan connect the south facing and north facing bedrooms. Electronic controls monitor individual room temperature and turn the fan on to circulate |
|
|
|
Dining Room
|
|
|
|
|
Kitchen / Dining Room
|
|
|
|
Dining Room / Entry
|
|
|
